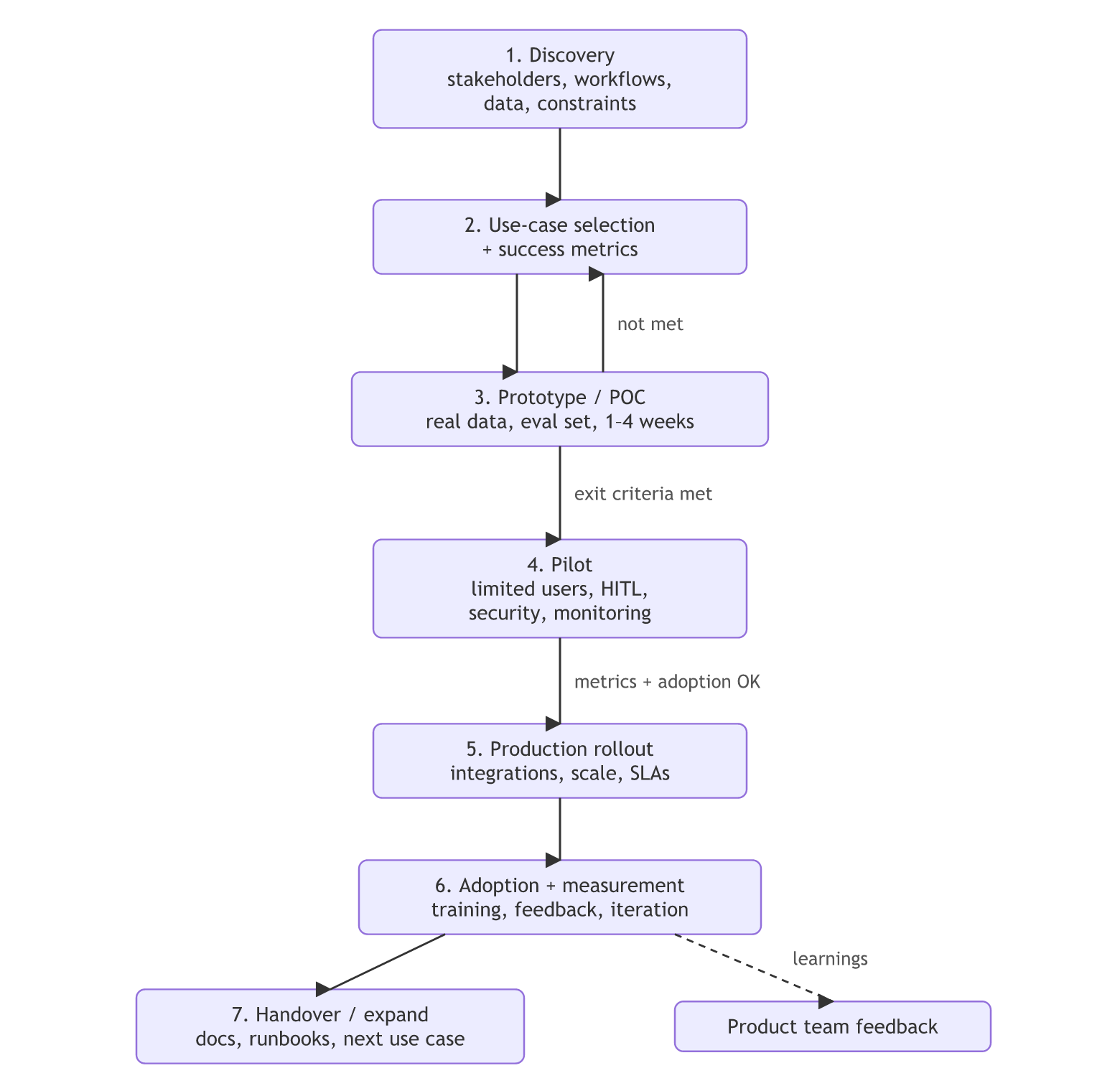

What does a typical FDE engagement lifecycle look like for an AI project?
30-second answerSay your answer out loud first, then reveal.

Exit criteria examples
| Stage | Exit criteria |
|---|---|
| POC | ≥ 85% accuracy on 200 SME-labelled cases; latency < 5s; security review started |
| Pilot | 30 users × 4 weeks; 25% handle-time reduction; no critical incidents; > 60% weekly active |
| Production | SLAs met; runbooks; customer team trained; monitoring and alerts live |
Key insight: most AI projects die between POC and production. The work there is security reviews, integrations, edge cases, change management and trust. Strong FDEs plan for that from day one.
